Importing temporary fencing to Canada isn’t just about finding the cheapest panels overseas – it’s about mastering a complex logistical puzzle that includes international shipping, Canadian customs regulations, steel import permits, and getting your fence from the port to your job site. This comprehensive guide walks you through the entire process, from calculating your true landed costs and choosing the right shipping terms to navigating CBSA requirements and avoiding costly demurrage fees that can derail your project timeline and budget.
From Factory to Fence Line: The Complete Blueprint for Importing Temporary Fencing to Canada
You’ve found that perfect temporary fencing supplier overseas with prices that make your accountant smile. But here’s where most contractors hit a wall – getting those fence panels from their factory to your Canadian job site without bleeding money or missing deadlines. International shipping feels like navigating a minefield of hidden fees, confusing paperwork, and regulations that seem designed to trip you up.
While most guides focus on what fence to buy, this blueprint tackles the real challenge: actually getting it here in one piece, on time, and on budget. We’re taking you through a specialized tour that’ll transform you from someone who just compares panel prices to a savvy importer who understands the whole game.
Your journey covers four essential areas:
- The Logistics War Room: Where you’ll plan your shipment strategy for maximum savings and efficiency.
- The Global Transit Hub: Learning how your fence travels across oceans and continents.
- The CBSA Gauntlet: Our exclusive deep-dive into Canadian customs and steel import requirements that most importers completely miss.
- The Final Mile: Getting your fence from Canadian ports to your actual work site.
By the time you finish this guide, you won’t just have temporary fencing – you’ll have complete control over your supply chain, protecting your budget, timeline, and sanity.
Hall 1: The Logistics War Room – Strategizing Your International Fence Shipment
Your first decisions about container size, shipping terms, and cost calculations will make or break your entire import operation before a single panel even moves.
Everything starts here in the planning phase. The choices you make in this room determine whether your import goes smoothly or becomes an expensive nightmare. Get this foundation right, and everything else flows naturally.
Full Container Load (FCL) vs. Less than Container Load (LCL): Which Makes Sense for Your Fence Order?
Your shipment size drives your entire freight strategy. Temporary fencing is bulky but stackable, so this choice impacts everything from cost to delivery speed. FCL means you rent an entire container just for your stuff, while LCL means sharing space with other importers’ cargo.
| Factor | FCL (Full Container Load) | LCL (Less than Container Load) |
|---|---|---|
| Cost Structure | Fixed rate per container. Better deal for larger volumes. | Priced by cubic meter or weight, whichever costs more. |
| Transit Time | Faster. Container goes straight from origin to destination. | Slower. Needs consolidation and de-consolidation stops. |
| Handling Risk | Lower risk. Sealed at factory, opened at destination. | Higher risk. Multiple handling points with other cargo. |
| Best For | Large projects, inventory builds (100+ panels typically). | Small orders, replacement parts, accessories like clamps. |
Decoding Incoterms (FOB, EXW, CIF): Who Pays for What and When
Incoterms are the universal language of international shipping. They spell out exactly when responsibility and costs shift from your supplier to you. Getting this wrong costs serious money. Here are the terms you’ll see most when importing temporary fencing:
- FOB (Free On Board): Your supplier handles everything until the fence panels are loaded on the ship. From that point, you own all costs, insurance, and risk. This usually gives Canadian importers the best balance of control and cost.
- EXW (Ex Works): You handle everything from their factory gate onward. Maximum control, but you’re also on the hook for everything that could go wrong from day one.
- CIF (Cost, Insurance, and Freight): Supplier arranges shipping all the way to your Canadian port. Sounds simple, but you lose control and suppliers often inflate their freight costs since you can’t see the breakdown.
Calculating Your True Landed Cost: The Real Price Tag Beyond Panel Costs
That price on your supplier’s quote is just the starting point. Your “landed cost” represents what you actually pay to get temporary fencing delivered and ready to install in Canada. Most contractors get blindsided by these additional expenses. Think of your total cost as a pie – the panels themselves are just one slice.
Your real landed cost breaks down like this:
- Product Cost: The supplier’s invoice price (typically around 60% of your total)
- Freight Costs: Ocean or air shipping from their port to Canada (roughly 20% of total)
- Customs and Duties: Tariffs, GST, and customs broker fees (about 15% of total)
- Inland Transport: Getting it from Canadian ports to your site, plus port fees and insurance (around 5% of total)
Hall 2: The Global Transit Hub – Navigating Ocean and Air Freight to Canada
Once you’ve got your strategy locked down, you need to understand the actual journey your fence panels take across the world and how to protect them during that trip.
With your planning complete, it’s time to move your product. This section covers the nuts and bolts of international transportation – how your temporary fencing travels from overseas ports to Canadian shores and what you need to know to keep things moving smoothly.
Ocean vs. Air Freight: Picking the Right Transport for Temporary Fencing
For heavy, bulky products like temporary fencing that don’t spoil, ocean freight makes the most sense financially. Air freight serves a completely different purpose and comes with a much higher price tag.
- Ocean Freight: The most cost-effective way to move bulk shipments. Perfect when you’re stocking inventory or supplying large projects where you can plan weeks or months ahead.
- Air Freight: Much more expensive and charged by weight. Reserve this for emergencies – like when you need replacement panels fast to avoid shutting down an active job site, or for shipping valuable accessories like security hardware.
Key Canadian Ports for Bulky Cargo Like Temporary Fencing
Canada’s huge geography makes your port choice critical for controlling costs and delivery times. Pick the right entry point and you’ll slash your inland transportation expenses. Here are your main options:
- Port of Vancouver: Canada’s biggest port and the main gateway for anything coming from Asia.
- Port of Prince Rupert: Growing alternative to Vancouver on the West Coast, known for excellent rail connections across Canada.
- Port of Montreal: Major entry point on the St. Lawrence Seaway for European and Mediterranean cargo.
- Port of Halifax: Important East Coast port with deep, ice-free harbor, handling cargo from Europe and Asia via the Suez Canal.
Proper Packing for International Shipping of Temporary Fencing
Good packing protects your investment during the long ocean journey with rough seas and multiple handling points. While your supplier handles the actual packing, you need to know what to request to ensure your temporary fencing arrives in perfect condition.

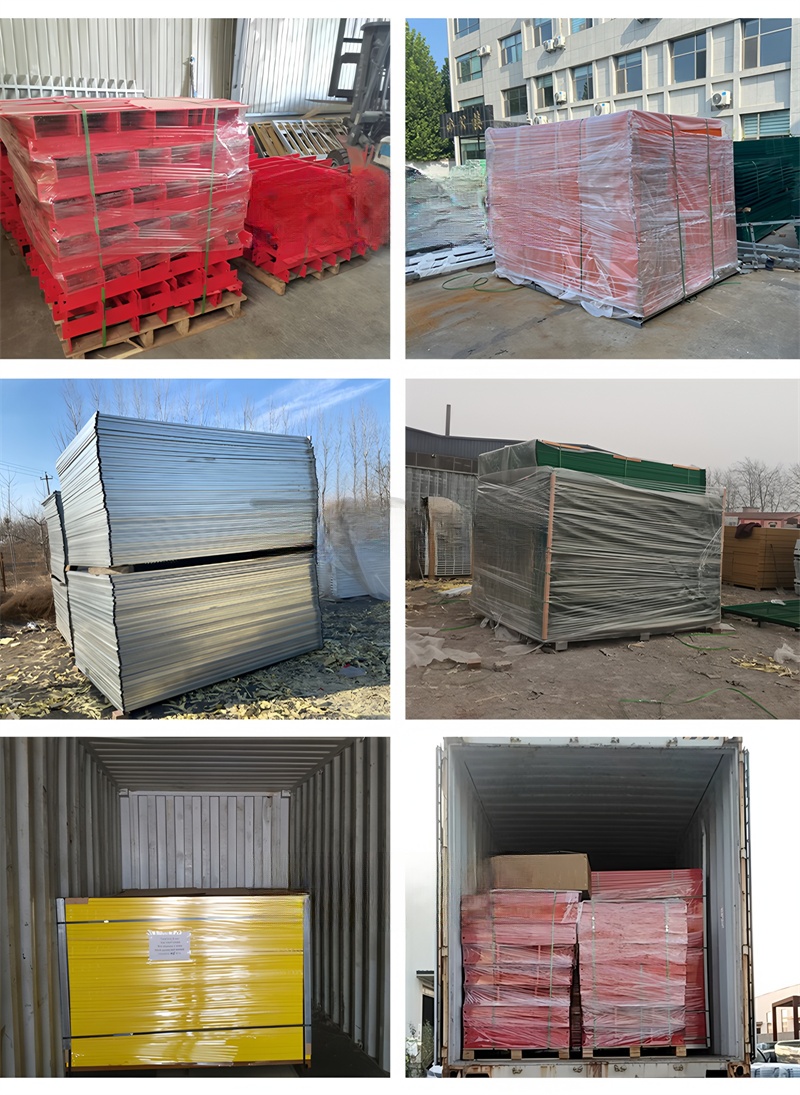

- Fence Panels: Ship panels stacked on heavy-duty steel pallets for easy forklift handling. Insist on bubble wrap or thick cardboard at the pallet base to protect the bottom panel’s finish from steel scratches.
- Feet and Clamps: Pack these loose items in separate steel mesh cages or solid wooden crates. This prevents loss inside the container and makes inventory counting much easier when everything arrives.
Portable Temporary Fencing Built for Canadian Conditions
DB Fencing offers durable, corrosion-resistant temporary fence panels designed to handle Canada’s weather. Benefit from factory-direct prices, quick response, customizable options, and reliable nationwide delivery for your construction, event, or safety needs.
Hall 3: The CBSA Gauntlet – Mastering Canadian Customs and Import Permits
This is where most importers crash and burn – the specific paperwork and marking requirements that the Canada Border Services Agency demands for steel fence imports.
Getting your temporary fencing into Canada involves way more than just paying duties. You’re dealing with specific and often confusing CBSA rules that trip up even experienced importers. Miss these details and you’ll face expensive delays and penalties.
Import Permits for Steel Fencing: Understanding General Import Permits
Here’s a critical detail that catches importers off guard. Since temporary fencing contains steel, it falls under Canada’s Import Control List. According to CBSA Memorandum D19-10-2, certain steel products require permit citations for entry.
- General Import Permit (GIP): For most commercial steel fence imports, you don’t apply for permits ahead of time. Instead, you must cite either GIP No. 80 (Carbon Steel) or GIP No. 81 (Specialty Steel Products) on your customs paperwork. This citation is mandatory, not optional.
- Country of Melt and Pour (COM): Steel imports require reporting where the raw steel was originally produced. A skilled customs broker ensures this gets reported correctly to avoid problems.
Country of Origin Marking Rules: Why That Made In Sticker Actually Matters
The CBSA takes marking requirements seriously. According to Memorandum D11-3-1, certain goods including iron or steel pipes and tubes that form your fence panel frames must clearly show their country of origin.
- Marking Methods: A simple sticker on pallet wrap won’t cut it. Rules require permanent marking on the actual goods through paint stenciling, die stamping, or etching. For pipe bundles, securely attached tags might work.
- End User Visibility: Markings must stay legible and durable enough for the final Canadian buyer to see. Fail this requirement and CBSA can detain your entire shipment until proper marking is completed – an expensive and time-consuming nightmare.
Customs Duties and Tax Calculations: Finding Your HS Code
Every product imported into Canada gets classified under a Harmonized System code. This 10-digit number determines your duty rate. Use the wrong code and you’ll either overpay or face future audits and penalties.
- Temporary fence panels typically fall under Chapter 73 of Canada’s Customs Tariff covering iron or steel articles, often in subheadings like 7308.90 for structures and parts or 7314.49 for cloth, grill, netting and fencing.
- A licensed customs broker provides the expertise you need for correct HS code classification. Their knowledge protects you from costly classification mistakes.
Essential Customs Documentation Checklist:
- ✓ Bill of Lading: Your shipping contract from the carrier
- ✓ Commercial Invoice: Must show seller, buyer, currency, values, and origin country
- ✓ Packing List: Detailed contents of each pallet and container
- ✓ Import Permit Citation: Correct GIP number noted on customs entry
Hall 4: The Final Mile – From Canadian Port to Project Site
Your temporary fencing has cleared customs, but managing the domestic delivery leg is where late fees and job site chaos can still derail everything you’ve worked for.
Your fence has landed and cleared CBSA inspection, but you’re not done yet. This final stretch from Canadian ports to your job site is where unexpected delays and costs can pile up if you don’t manage it precisely.
Understanding Customs Brokers: Your Essential CBSA Navigator
A customs broker serves as your licensed agent who deals directly with CBSA on your behalf. For complex imports like temporary fencing with specific steel regulations, their expertise isn’t just helpful – it’s absolutely essential.
Your broker handles:
- Correct HS Code classification for your goods
- Preparation and submission of all electronic customs documentation
- Payment arrangement for duties and GST to the Receiver General for Canada
- Problem-solving with CBSA to ensure timely cargo release
Inland Transportation Options: Rail vs. Trucking Across Canada
Once CBSA releases your container, you need to get it to your final destination. Your transportation choice depends heavily on distance and urgency.
- Rail Transport: For long hauls like Vancouver to Calgary or Toronto, rail offers the most cost-effective method for moving full containers across the country.
- Truck Transport (Drayage): Trucks always play a role. They handle short-haul trips from port terminals to nearby rail yards. For shorter final trips like Montreal port to an Ottawa site, trucks might handle the entire journey. You’ll need truck coordination for pickup from rail yards to your final site.
On-Site Delivery Coordination and Avoiding Demurrage Penalties
Timing becomes critical in the final mile. When your container reaches the port or rail yard, you get limited free days to pick it up. Miss these deadlines and expensive penalty fees start accumulating.
- Demurrage Fees: Port terminals charge these penalties when you don’t pick up containers within allotted free time (typically 2-4 days).
- Detention Fees: Shipping lines charge these when you keep their container too long before returning it empty after unloading.
- Site Logistics: Avoid detention charges by having proper equipment (forklift with adequate capacity) and crew ready to unload quickly when your container arrives at the project site.
Portable Temporary Fencing Built for Canadian Conditions
DB Fencing offers durable, corrosion-resistant temporary fence panels designed to handle Canada’s weather. Benefit from factory-direct prices, quick response, customizable options, and reliable nationwide delivery for your construction, event, or safety needs.
The Exit: Your Complete Import Mastery
You’ve completed the full tour and discovered that importing temporary fencing successfully requires mastering logistics, not just finding the cheapest panels. By thinking beyond panel prices to strategically plan freight, navigate Canadian customs requirements, and manage final delivery, you’ve transformed from someone who just buys fence to someone who executes complete global supply chain operations. You now have the blueprint to protect your budget, timeline, and project success.
When you’re ready to put this blueprint into action, partner with experts who handle this process daily. Let professionals manage the headaches of international freight and customs while you focus on your core business.
Contact our logistics specialists today for a transparent, comprehensive quote covering the entire journey from factory to fence line.
Expert Q&A: Your Import and Logistics Questions Answered
Q: How long does temporary fencing take to ship from China to Canada by ocean?
A: Plan for 4-6 weeks total delivery to Western Canada. This includes ocean transit (2-4 weeks to ports like Vancouver) plus port handling and customs clearance time. For Central or Eastern Canada destinations, add another 1-2 weeks for inland rail transport.
Q: What are the top 3 shipping mistakes to avoid when importing fencing?
A: First, miscalculating landed cost by forgetting customs duties, brokerage fees, and inland freight leads to major budget shocks. Second, using wrong Incoterms like EXW or CIF without understanding full cost and liability implications causes unexpected charges and loss of control. Third, incomplete documentation – not having correct Commercial Invoice, Bill of Lading, and permit information ready causes the most expensive delays and demurrage fees.
Q: How do I find the correct HS/Tariff Code for my fence panels?
A: Work with a licensed customs broker for the most reliable classification since they’re tariff experts. You can also search the Canadian Customs Tariff online through government resources. Most temporary fence panels appear in Chapter 73. Using incorrect codes leads to audits and financial penalties.
Q: What separates a General Import Permit from a Specific Import Permit?
A: A GIP like GIP 80 for steel provides standing authorization allowing any Canadian resident to import specified goods by simply citing the permit number on customs documents. A Specific Import Permit gets issued by Global Affairs Canada for one particular shipment, typically for goods under strict quotas like certain agricultural products.
Q: What happens if my goods arrive without correct country of origin marking?
A: CBSA has authority to detain your shipment. You’ll receive a notice requiring proper marking before release. This often means moving goods to a bonded warehouse for marking work like stenciling, which adds significant cost and delays to your project.
Q: Who handles responsibility for shipping damage?
A: This depends on your Incoterm choice and insurance coverage. With recommended FOB terms, risk transfers to you once goods load onto the vessel. This makes purchasing your own cargo insurance policy crucial. While CIF terms include insurance, coverage is often minimal and claims can be very difficult to collect.
